East Linton's New Station - Progress of Construction

A collection of photographs taken on the day of the station opening can be seen by clicking on this paragraph.

Tom Dickson, our Membership Secretary, has undertaken to photograph the progress during construction and RAGES would like to recognise his many visits to East Linton with his camera to make this record.

Selected images will be shown here with the latest at the top of this web page and captions below each photograph.

East Linton Station Construction - 2023-12-13

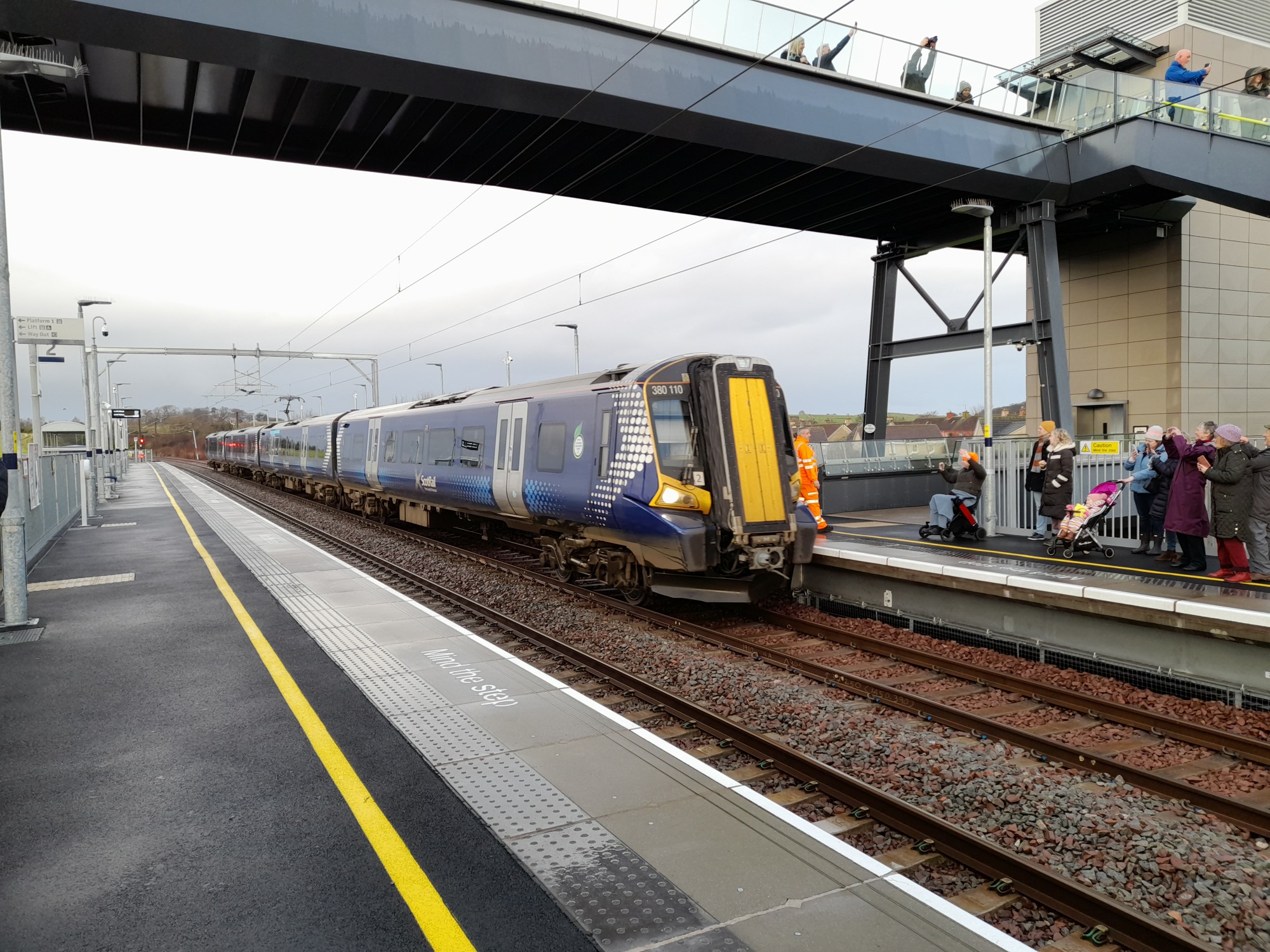

Fiona Hyslop, MSP, Minister for Transport, at the official opening of East Linton station.    13/12/2023

East Linton Station Construction - 2023-12-13

The first train to stop at East Linton station.    13/12/2023

East Linton Station Construction - 2023-11-17

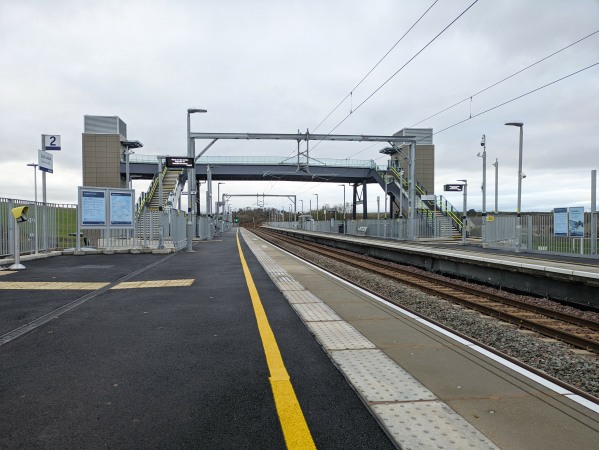

Station Platforms - Photo: Network Rail.    17/11/2023

East Linton Station Construction - 2023-11-13

TPE train passing, but soon to be stopping.    13/11/2023

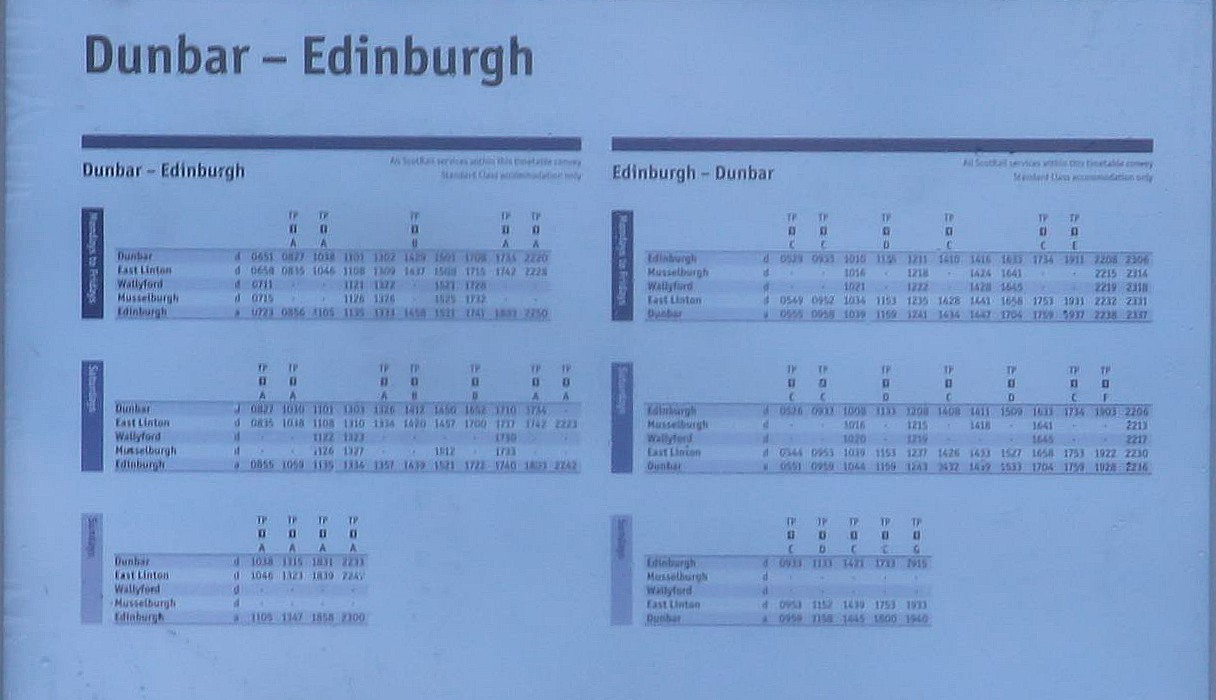

East Linton Station Construction - 2023-11-13

Timetables.    13/11/2023

East Linton Station Construction - 2023-11-13

Notice Board and Ticket Machine.    13/11/2023

East Linton Station Construction - 2023-11-02

Car charging points are installed.    02/11/2023

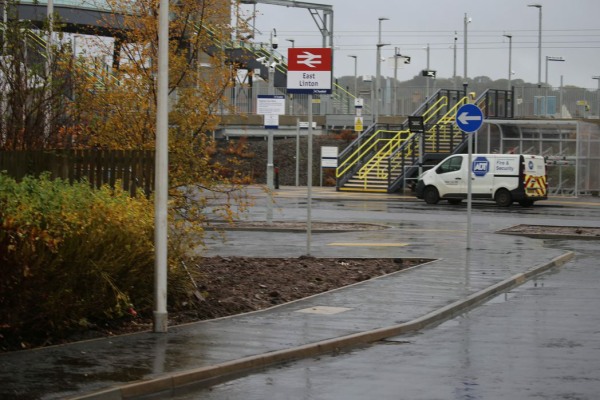

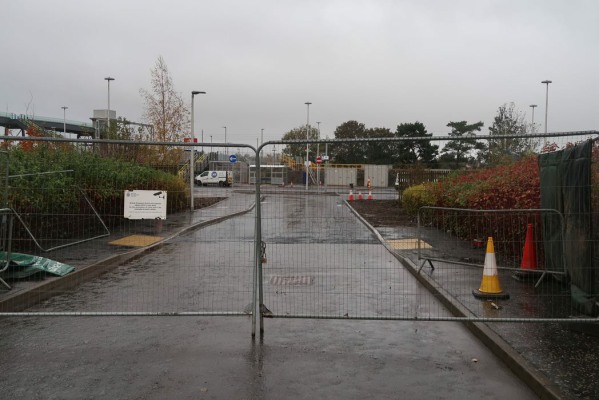

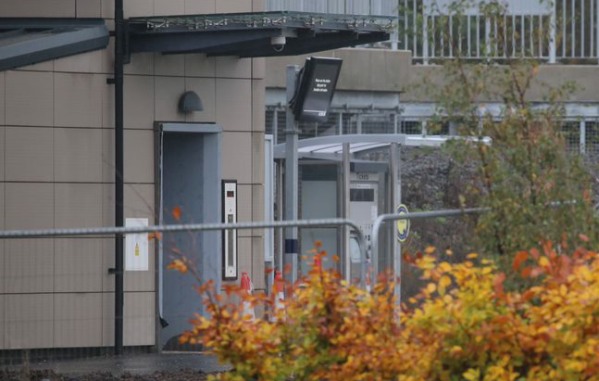

East Linton Station Construction - 2023-10-27

Ticket machine to the right of the lift door.    27/10/2023

East Linton Station Construction - 2023-10-27

Most of the signage appears to be erected.    27/10/2023

East Linton Station Construction - 2023-10-27

Car park markings.    27/10/2023

East Linton Station Construction - 2023-10-27

View of the car park and lampposts.    27/10/2023

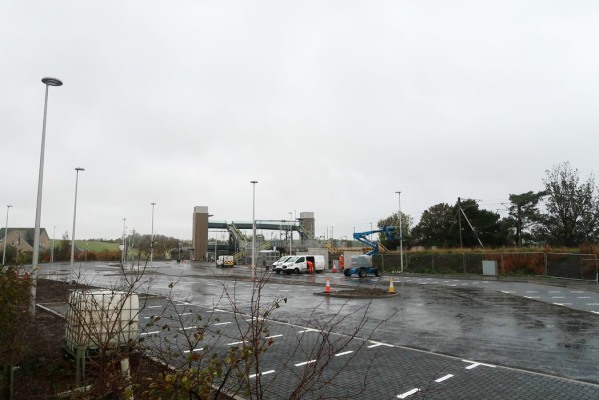

East Linton Station Construction - 2023-10-27

Main access to the station.    27/10/2023

East Linton Station Construction - 2023-09-20

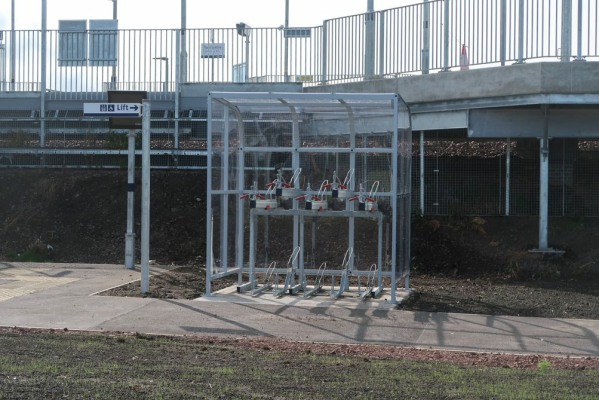

Cycle shed installed.    20/09/2023

East Linton Station Construction - 2023-07-23

Station sign now erected.    23/07/2023

East Linton Station Construction - 2023-07-23

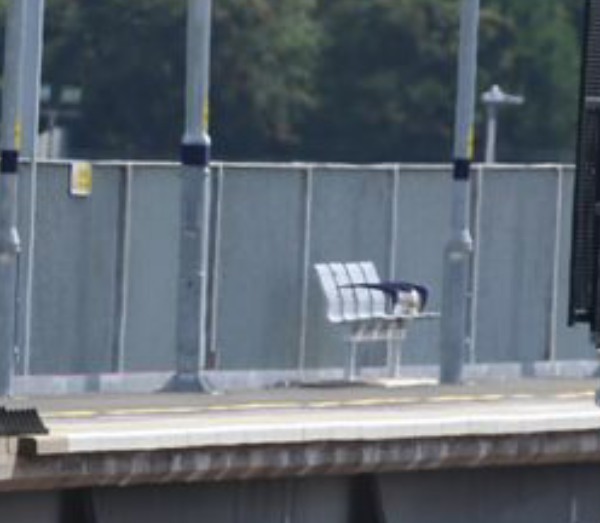

There is now a seat on the platform to await the next train.    23/07/2023

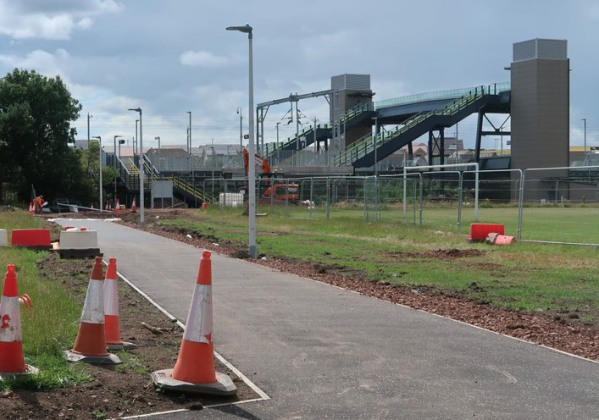

East Linton Station Construction - 2023-07-13

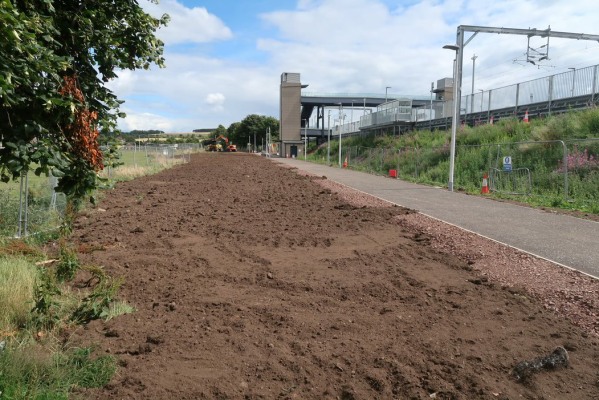

Landscaping alongside access path is proceeding.    13/07/2023

East Linton Station Construction - 2023-07-13

Information board installed.    13/07/2023

East Linton Station Construction - 2023-07-13

Lamp posts installed on the access path.    13/07/2023

East Linton Station Construction - 2023-07-13

Station sign waiting for installation.    13/07/2023

East Linton Station Construction - 2023-03-31

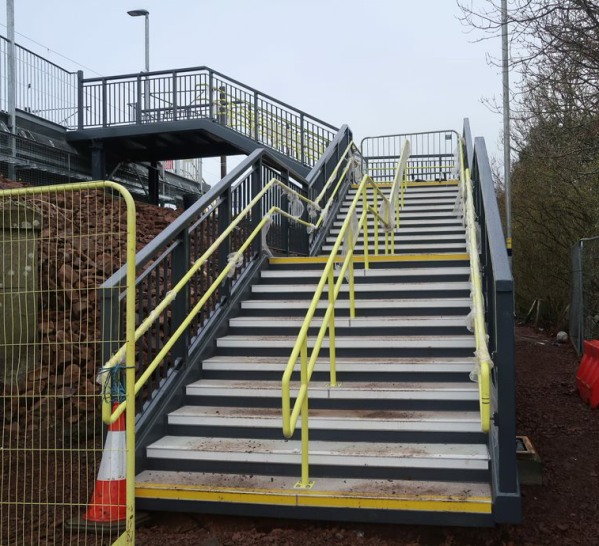

One of the emergency egress stairs installed.    31/03/2023

East Linton Station Construction - 2023-03-24

Foundations for one of the emergency egress stairs.    24/03/2023

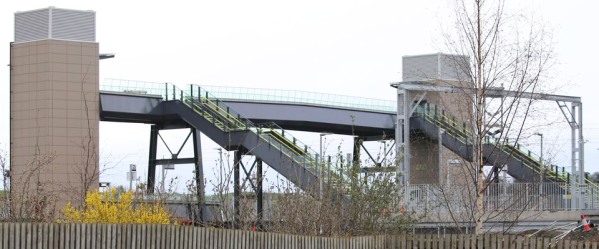

East Linton Station Construction - 2023-03-24

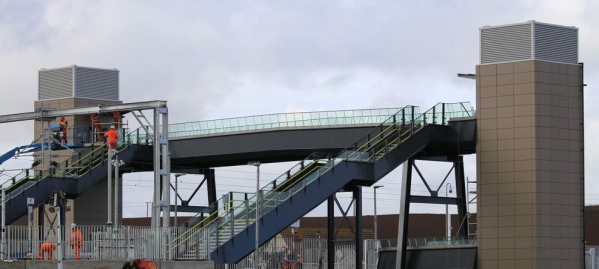

The bridge looking complete.    24/03/2023

East Linton Station Construction - 2023-03-17

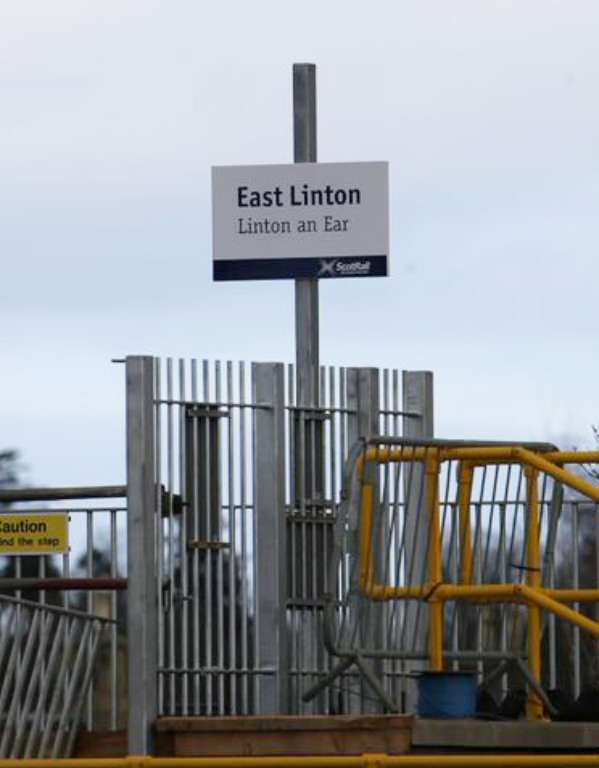

One of the station signs.    17/03/2023

East Linton Station Construction - 2023-03-17

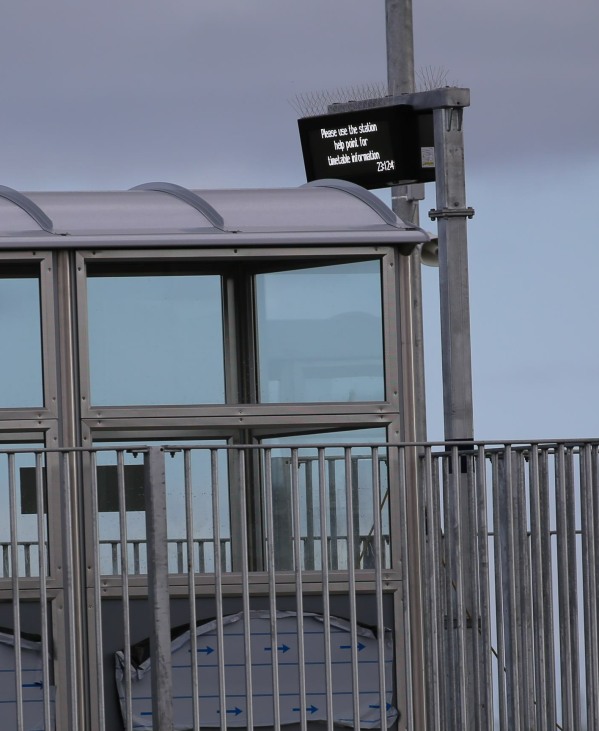

The information screens are working.    17/03/2023

East Linton Station Construction - 2023-03-17

Scaffolding has been removed from the lift towers.    17/03/2023

East Linton Station Construction - 2023-02-27

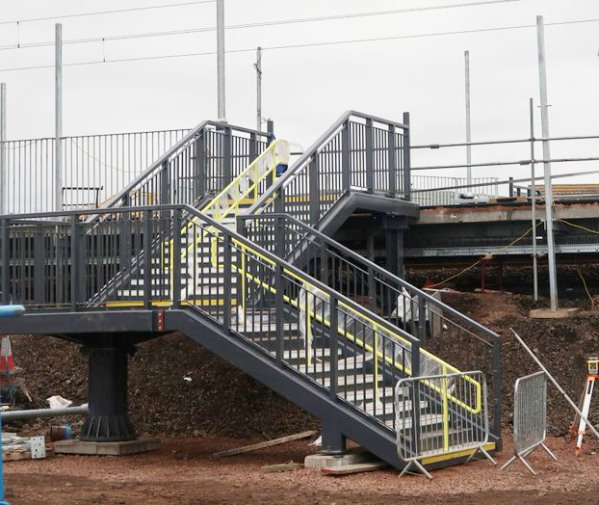

Stairs from ground level to platforms are being fitted.    27/02/2023

East Linton Station Construction - 2023-02-17

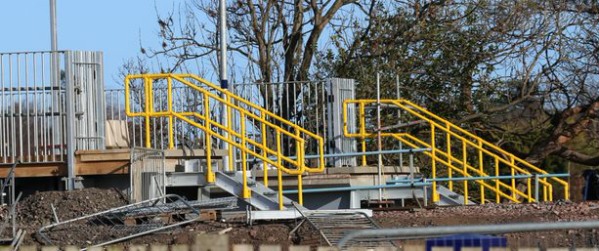

Emergency steps at platform ends are fitted.    17/02/2023

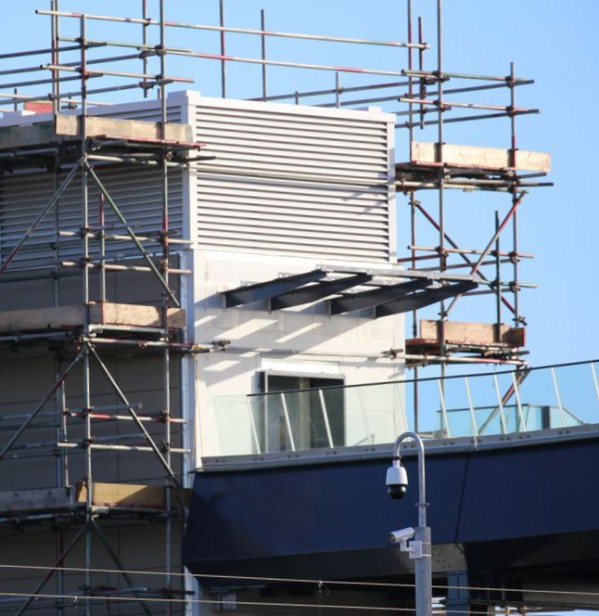

East Linton Station Construction - 2023-02-17

Louvres fitted to lift towers.    17/02/2023

East Linton Station Construction - 2023-02-08

Repeater signal (round disk on the left) to alert drivers to the state of the next signal which is unseen at the far end of the platform.    08/02/2023

East Linton Station Construction - 2023-02-08

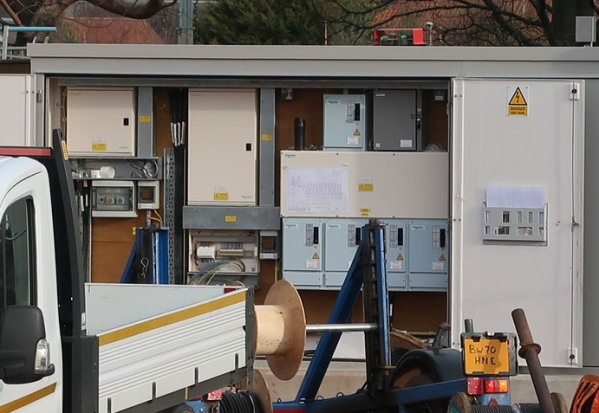

Electrical panel work progresses.    08/02/2023

East Linton Station Construction - 2023-02-08

Glass panels on stairs and bridge more or less complete.    08/02/2023

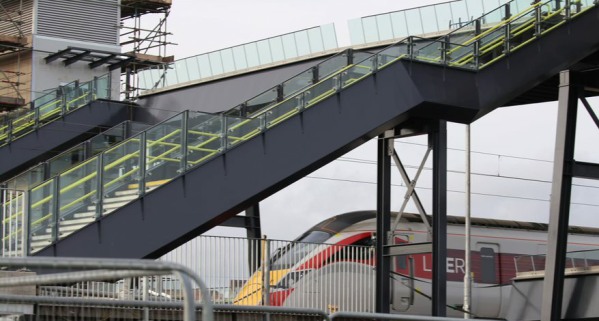

East Linton Station Construction - 2023-02-08

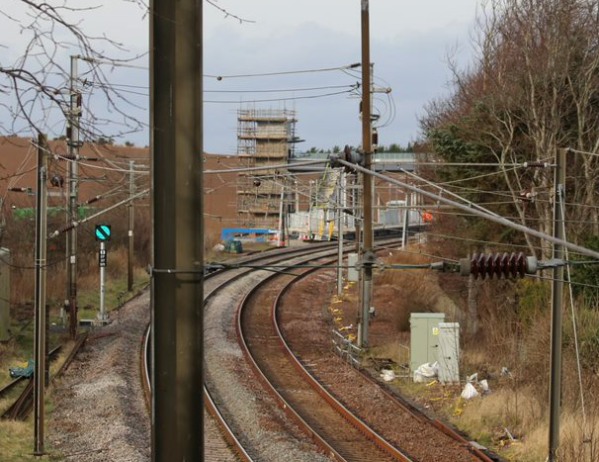

General view.    08/02/2023

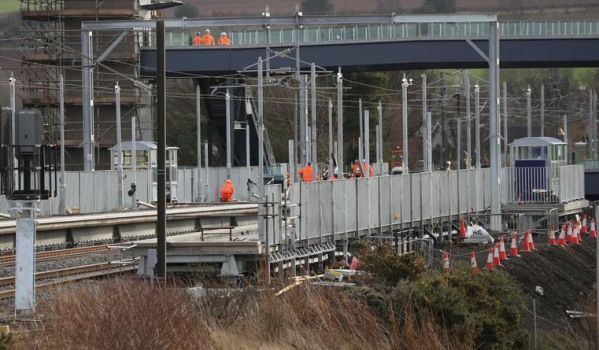

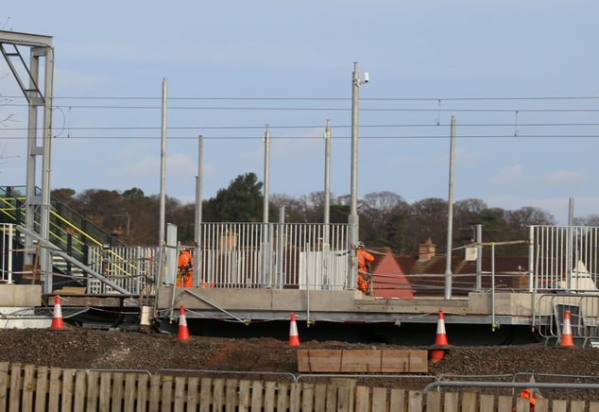

East Linton Station Construction - 2023-02-08

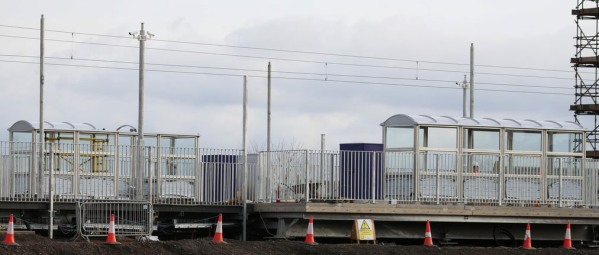

Platform shelters are installed.    08/02/2023

East Linton Station Construction - 2023-02-08

Ground level to platform stairs have been delivered.    08/02/2023

East Linton Station Construction - 2023-02-08

Lighting and CCTV posts being installed.    08/02/2023

East Linton Station Construction - 2023-01-21

Landscaping of the platform embankments continues.    21/01/2023

East Linton Station Construction - 2023-01-21

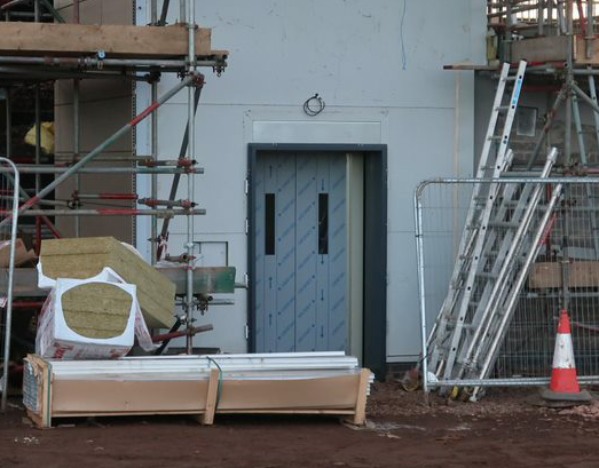

Lift doors installed.    21/01/2023

East Linton Station Construction - 2023-01-21

View of the new station from the site of the old.    21/01/2023

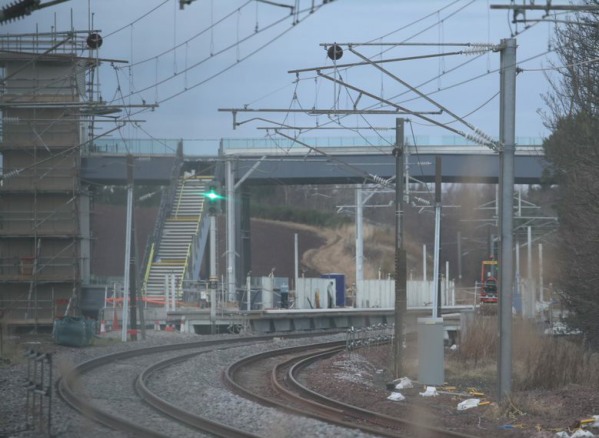

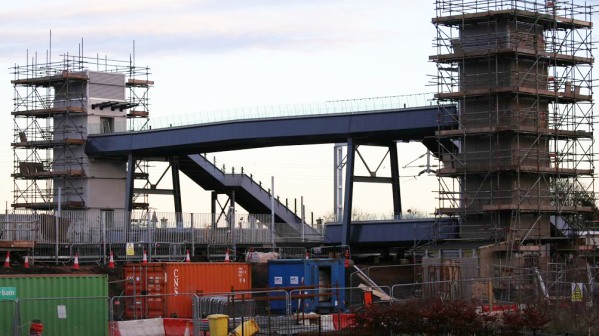

East Linton Station Construction - 2023-01-21

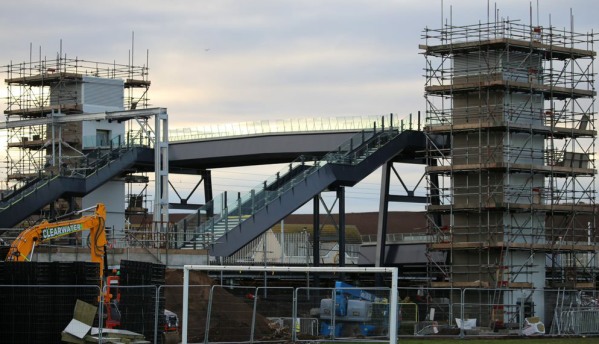

Bridge glass works from the other side.    21/01/2023

East Linton Station Construction - 2023-01-21

Bridge glass works looks complete.    21/01/2023

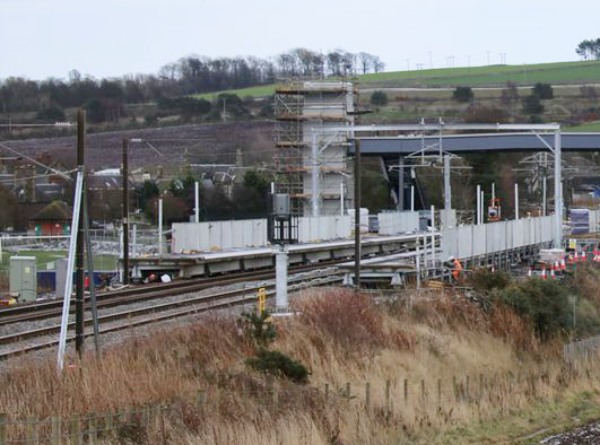

East Linton Station Construction - 2022-10-16

More platform barriers in place.    16/10/2022

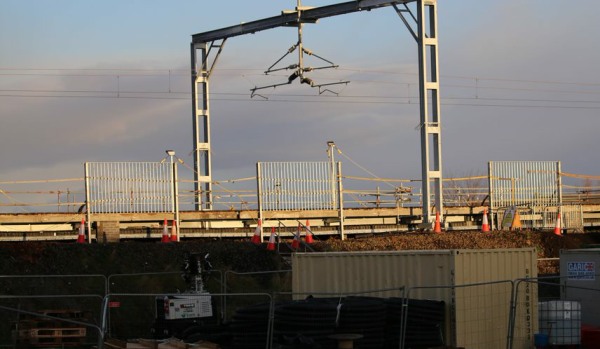

East Linton Station Construction - 2022-10-12

Another new signal.    12/10/2022

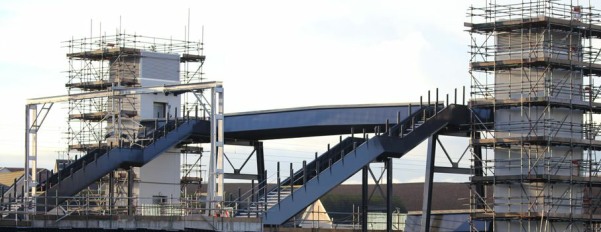

East Linton Station Construction - 2022-10-12

Permanent platform barriers now being installed.    12/10/2022

East Linton Station Construction - 2022-10-12

Platform stairs showing steps.    12/10/2022

East Linton Station Construction - 2022-10-12

Platform stairs in place.    12/10/2022

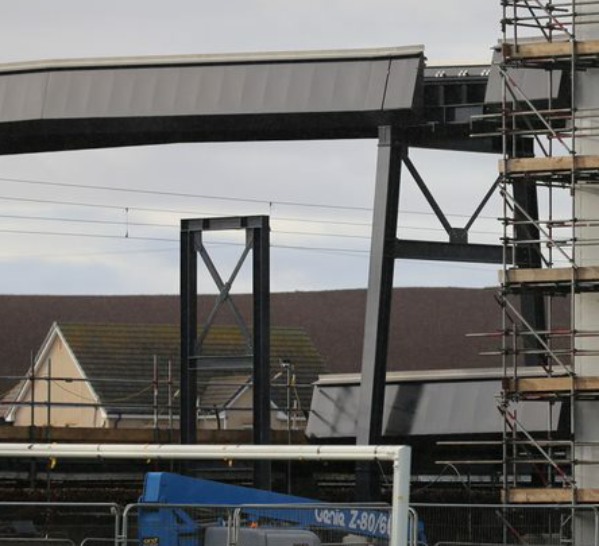

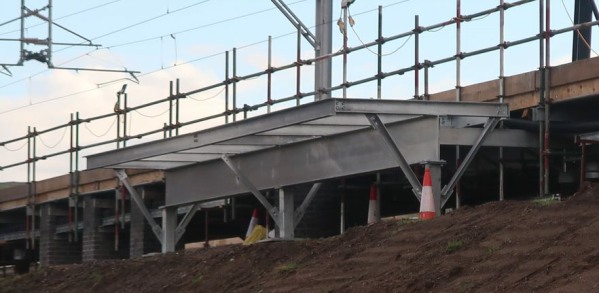

East Linton Station Construction - 2022-11-20

Platform side extension for shelter.    20/11/2022

East Linton Station Construction - 2022-11-20

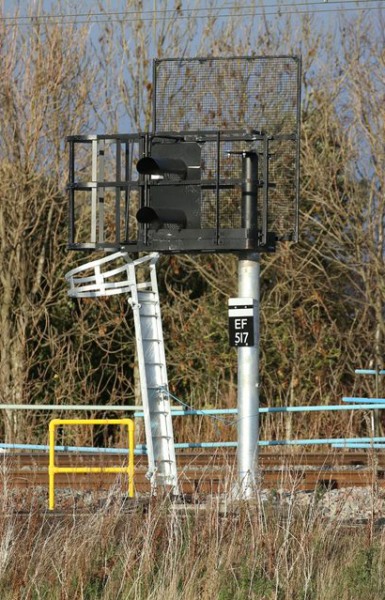

New down signal facing away from track before commissioning.    20/11/2022

East Linton Station Construction - 2022-11-20

Support frame installed for platform stairs.    20/11/2022

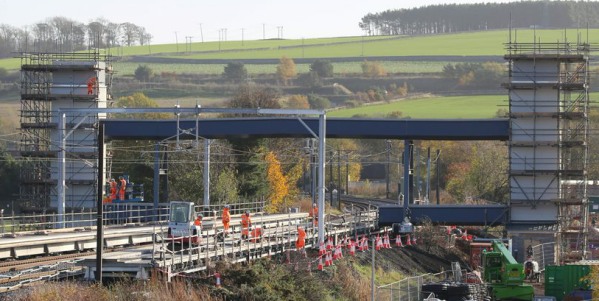

East Linton Station Construction - 2022-11-09

On both lift towers the louvre vents have been installed at the top of each tower.    09/11/2022

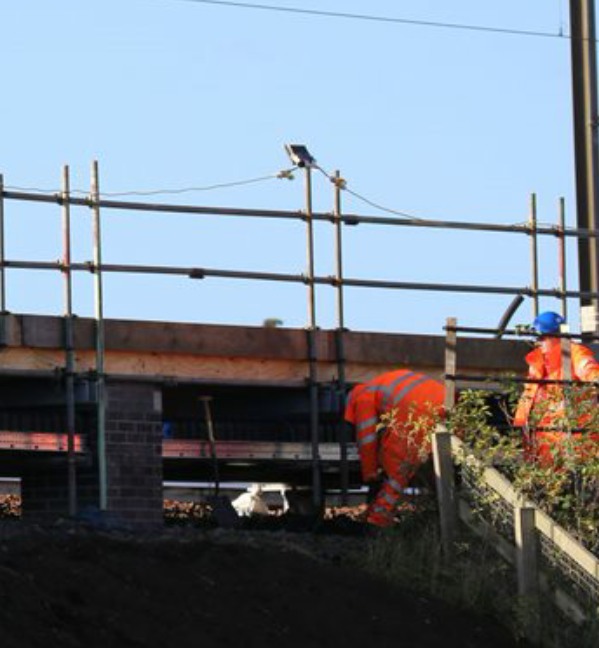

East Linton Station Construction - 2022-11-09

Temporary lighting has been installed to facilitate nighttime working.    09/11/2022

East Linton Station Construction - 2022-10-11

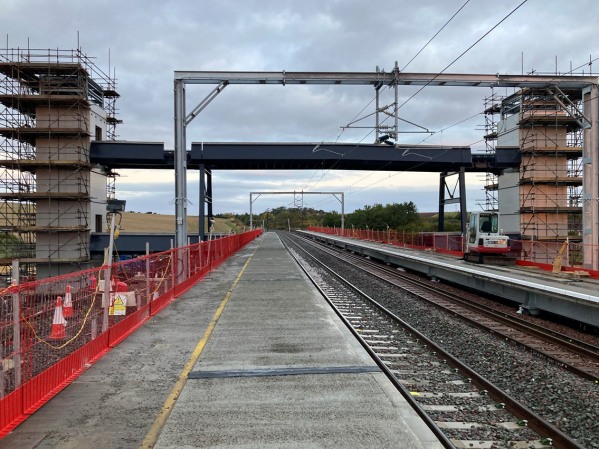

The footbridge from the platform. Photo: Network Rail. There is a video of the installation of the link span here.     11/10/2022

East Linton Station Construction - 2022-10-09

The footbridge from the other side.    09/10/2022

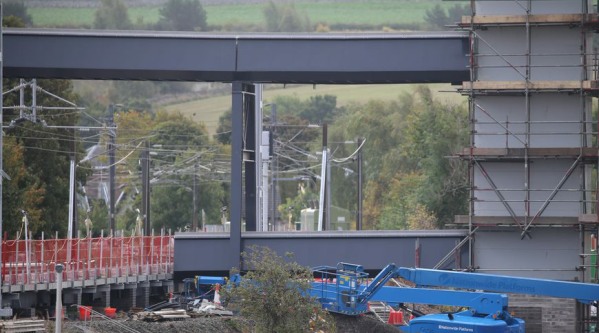

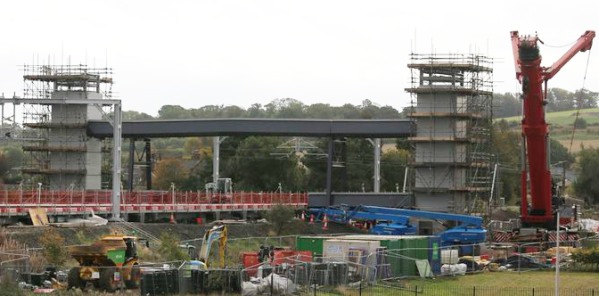

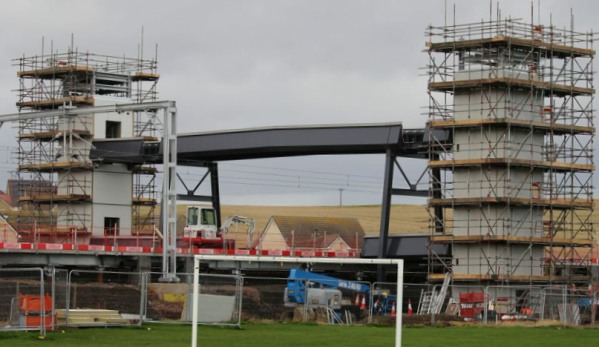

East Linton Station Construction - 2022-10-09

Showing the link to the platform.    09/10/2022

East Linton Station Construction - 2022-10-09

The footbridge with the link span in place a day later.    09/10/2022

East Linton Station Construction - 2022-10-08

The footbridge before the link span is put in place.    08/10/2022

East Linton Station Construction - 2022-10-08

Opening in the lift tower for the link span.    08/10/2022

East Linton Station Construction - 2022-10-08

The lift room.    08/10/2022

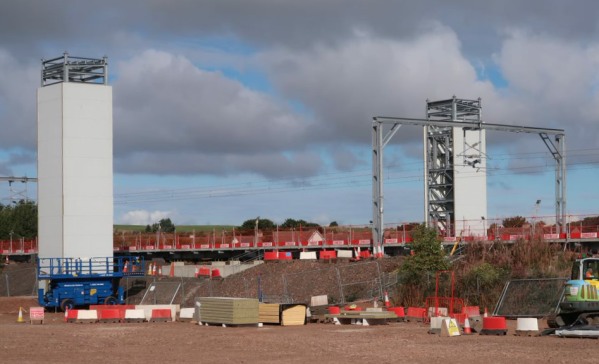

East Linton Station Construction - 2022-09-23

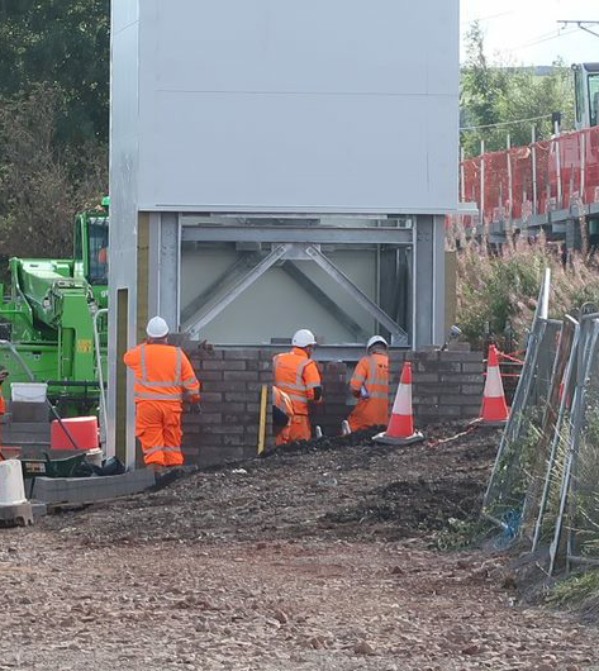

Cladding is progressing well.    23/09/2022

East Linton Station Construction - 2022-09-23

Brickwork for the lift motor room.    23/09/2022

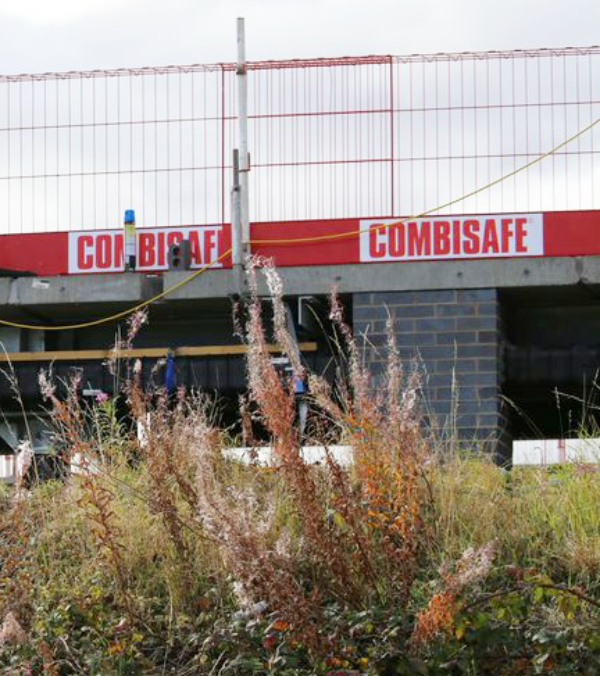

East Linton Station Construction - 2022-09-16

Brickwork columns continue to be built under the platforms.    16/09/2022

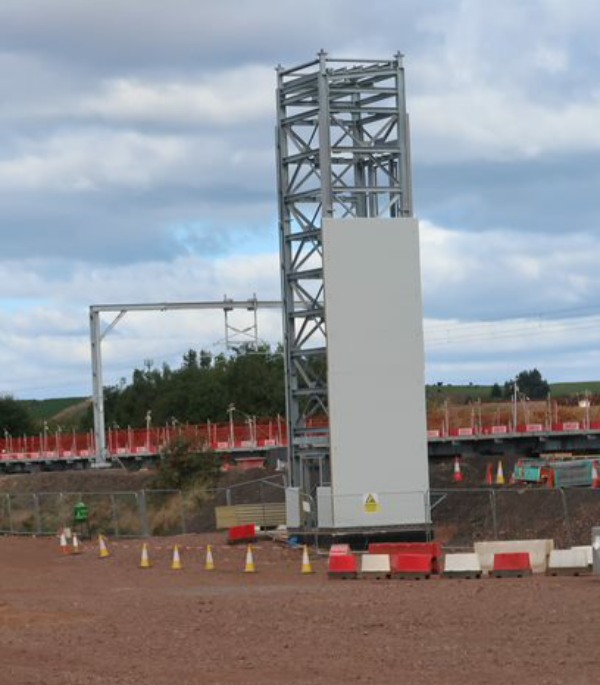

East Linton Station Construction - 2022-09-16

The lift shafts have started to be clad.    16/09/2022

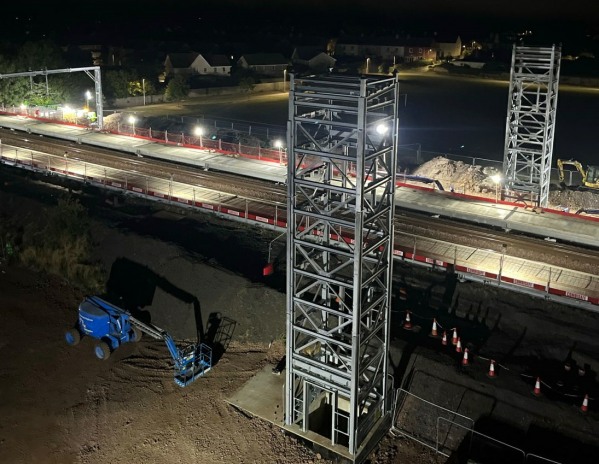

East Linton Station Construction - 2022-09-02

The lift shafts and the platforms as seen from the air. Photo: Network Rail    02/09/2022

East Linton Station Construction - 2022-08-31

The lift shafts are now in place.    31/08/2022

East Linton Station Construction - 2022-08-28

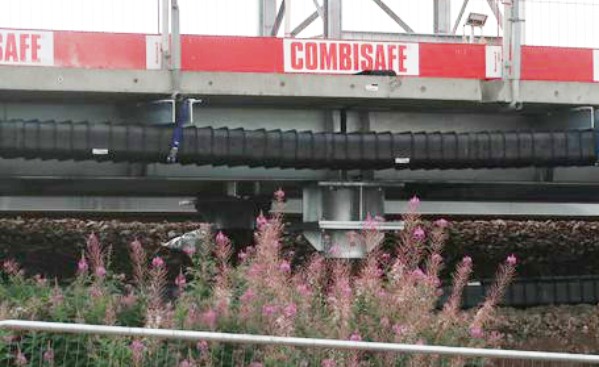

The plastic conduit pipework for cabling can be seen under the platform.    28/08/2022

East Linton Station Construction - 2022-07-29

This photograph, taken from the bridge over the tracks where the old station was, shows why the curve in the tracks has resulted in the site of the new station being further west. The start of the new station can be seen at the end of the curve.    29/07/2022

East Linton Station Construction - 2022-07-22

Car park construction has started.    22/07/2022

East Linton Station Construction - 2022-07-22

Piling for the platform 2 lift tower.    22/07/2022

East Linton Station Construction - 2022-07-13

Piling for the platform 1 lift tower.    13/07/2022

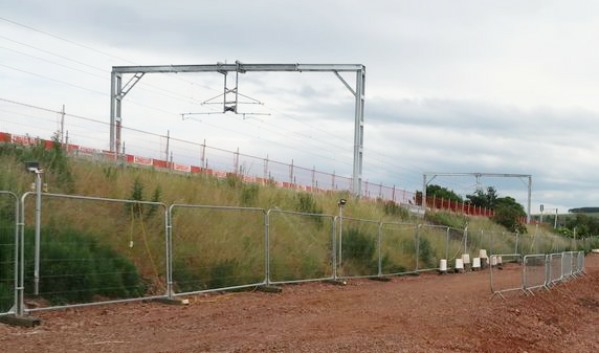

East Linton Station Construction - 2022-06-16

Safety railings are being fitted on the platforms.    16/06/2022

East Linton Station Construction - 2022-06-13

Site of the lift tower?    13/06/2022

East Linton Station Construction - 2022-06-11

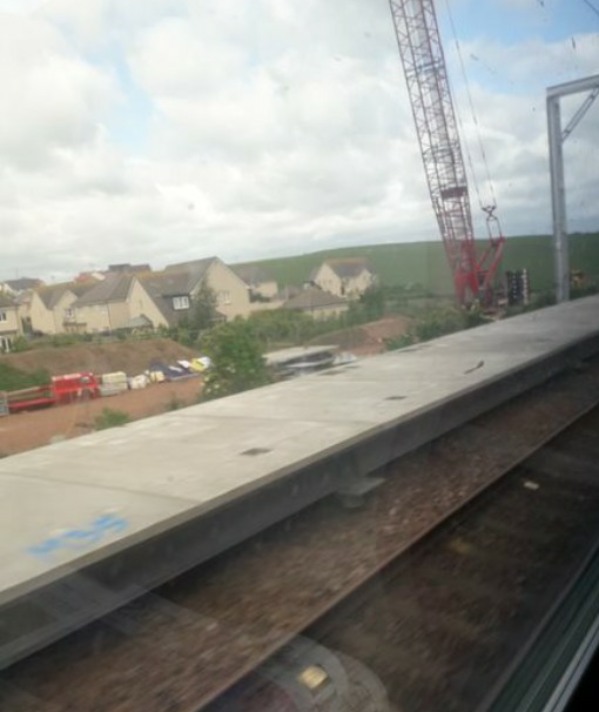

Platform 2 from a passing train. Photo by John Yellowlees.    11/06/2022

East Linton Station Construction - 2022-06-09

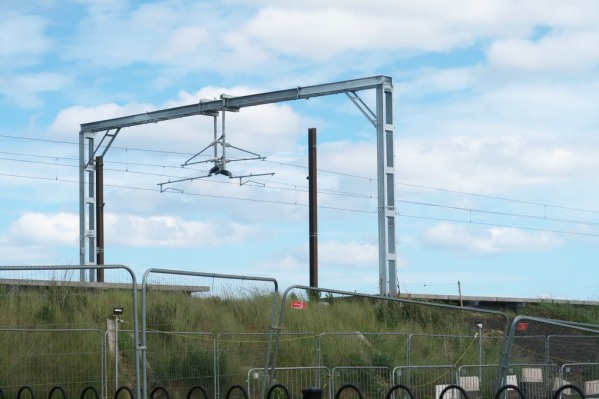

The overhead wires are now moved to the new gantries and the old masts are being removed.    09/06/2022

East Linton Station Construction - 2022-05-30

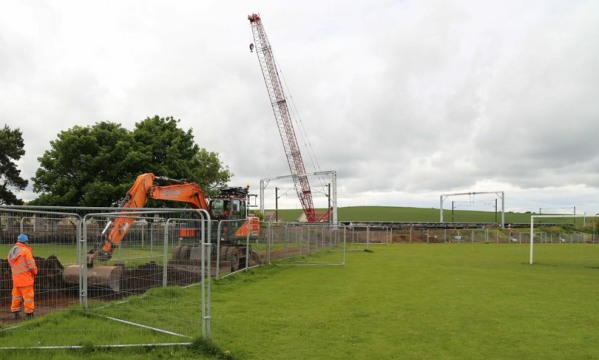

The new overhead line gantries will replace the single masts which would have been within the platform width. Also the access pathway is being reinforced for the heavy plant, but will be re-instated when work is complete.    30/05/2022

East Linton Station Construction - 2022-05-24

Some of the second platform is now in place.    24/05/2022

East Linton Station Construction - 2022-05-16

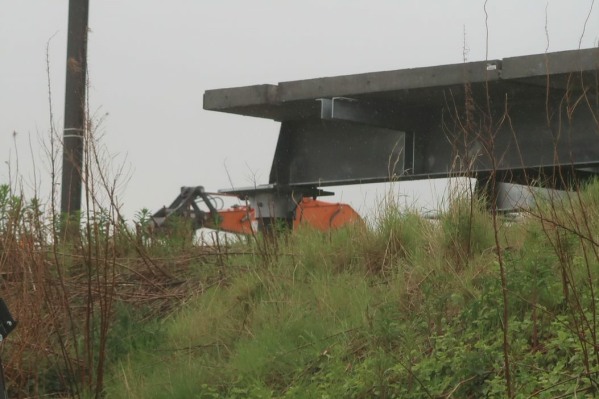

A lot of the first platform is now in place.    16/05/2022

East Linton Station Construction - 2022-05-16

Platform fixing onto the "top hats".    16/05/2022

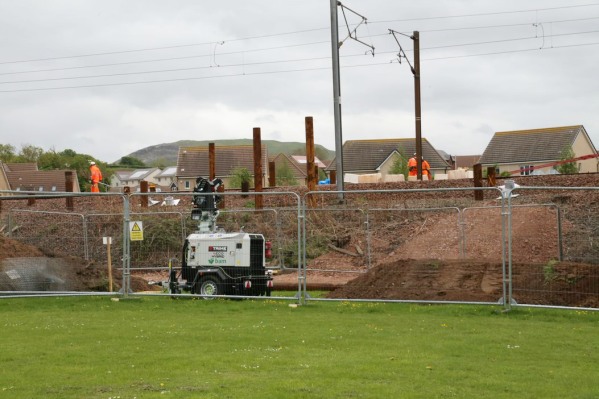

East Linton Station Construction - 2022-05-13

Station construction here is different from Reston. This shows the "top hats" which are placed on top of some of the pilings.  The platform sections are then bolted to them.    13/05/2022

East Linton Station Construction - 2022-05-13

Crane being erected to install platform sections. Also seen are some of the steel platform sections.    13/05/2022

East Linton Station Construction - 2022-04-29

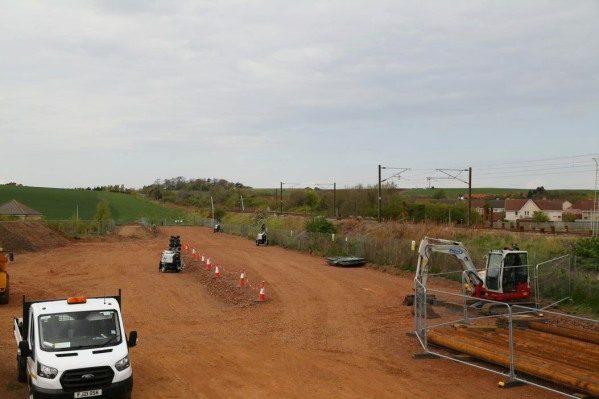

Preparation work progresses.    29/04/2022

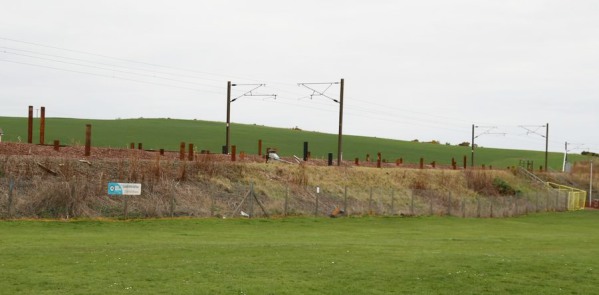

East Linton Station Construction - 2022-04-15

Piling for the platforms.    15/04/2022

East Linton Station Construction - 2022-04-14

Laying a temporary roadway through the park to allow machinery to access the platform areas.  Photo: A Cosgrove.    14/04/2022

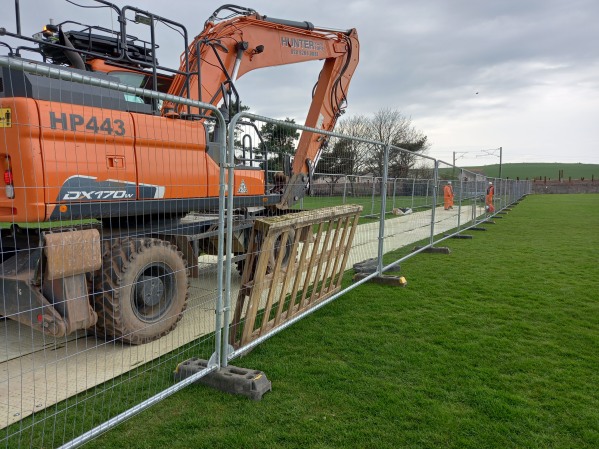

East Linton Station Construction - 2022-04-14

Laying a temporary roadway through the park to allow machinery to access the platform areas.  Photo: A Cosgrove.    14/04/2022

East Linton Station Construction - 2022-04-13

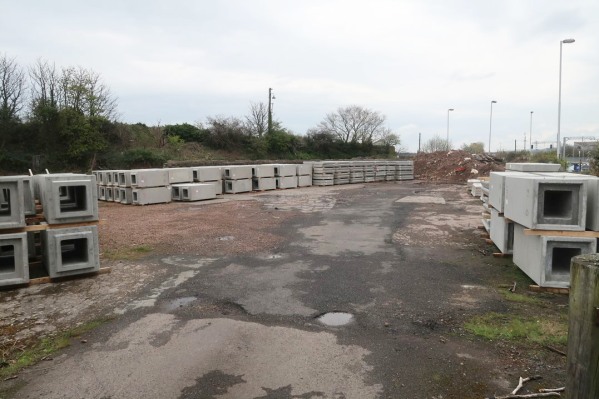

Station platform components being stored at Dunbar.    13/04/2022

East Linton Station Construction - 2022-03-19

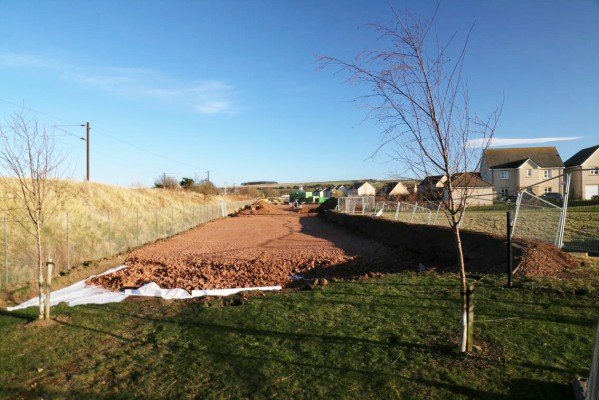

Hardcore being laid.    19/03/2022

East Linton Station Construction - 2022-02-27

Piling columns are now appearing along the track side.    27/02/2022

East Linton Station Construction - 2022-02-04

One of many lorries removing earth from the site.    04/02/2022

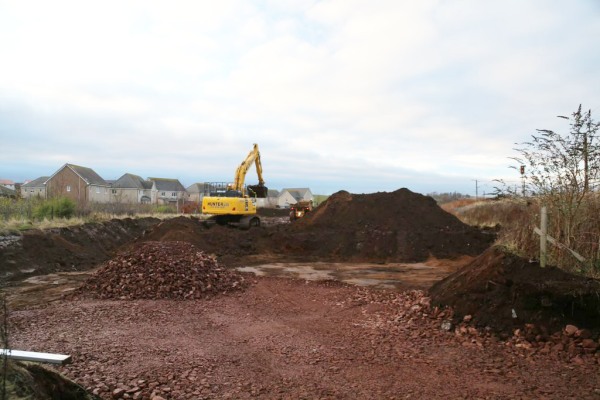

East Linton Station Construction - 2021-12-08

Site clearance begins for site offices.    08/12/2021

East Linton Station Construction - 2020-03-06

Drilling taking place for survey work in the park area behind the main street    06/03/2020

East Linton Station Construction - 2020-03-06

Drilling site complex is located in the new housing area next to the Mart    06/03/2020
